Special Reports - Local Worker Utilization Zip List Report

Modified on Thu, 12 Dec, 2024 at 6:16 AM

Report Description: this report breaks down craft utilization by two separate date ranges. The report can group by “Zip” list depending on the set up of zips or “list names” and report parameters will define information returned.  It contains the following information:

  • Project name
  • Project code
  • Name of contractor
  • Crafts selected
  • Date ranges selected
  • Total project hours to date
  • Total forecasted project hours
  • Total hours percent complete
  • Percentage craft hours 1st date range
  • Percentage craft hours 2nd date range
  • Cumulative craft hours to date
  • Percentage of cumulative hours
  • Hours broke out by zip lists
  • Hours broke out by journeyman
  • Hours broke out by apprentice
  • Hours broke out by ethnicity
  • Hours broke out by gender


Preconditions: zip lists will need to be created for this report to work for any data you’re looking for; zip lists can be created and maintained under Set Up > Zip Codes Setup

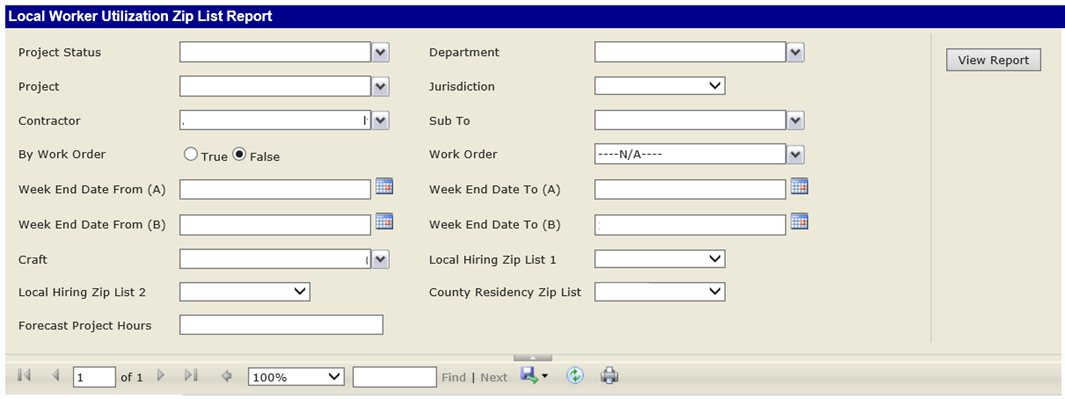

Parameters:

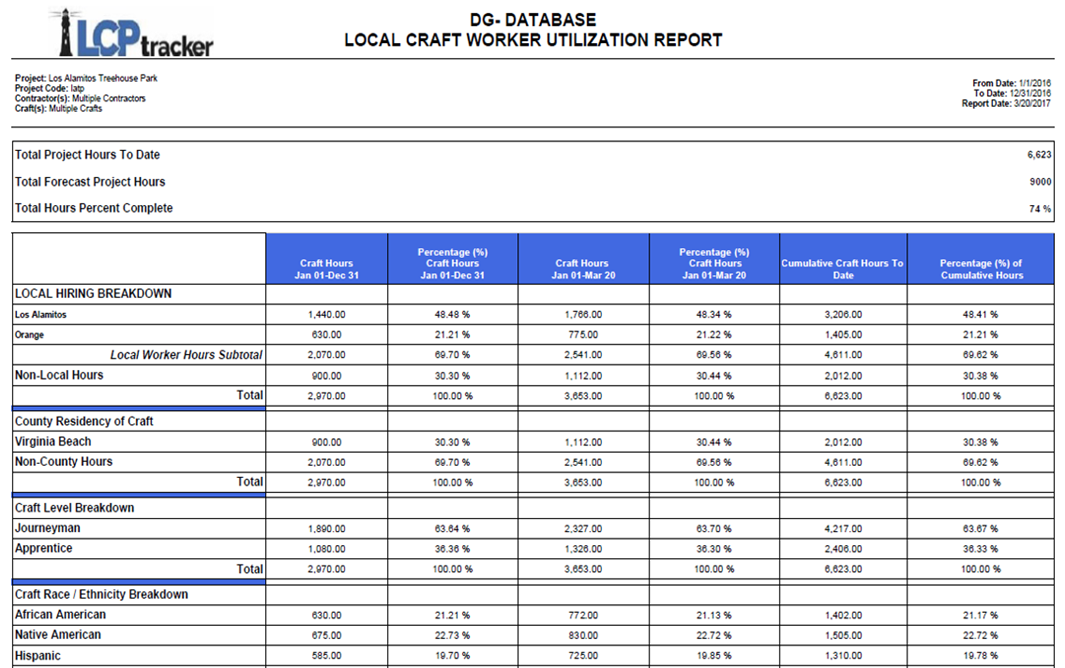

Report Sample:

Note: The report name is different than the name used to run the report.  The report will be called Local Craft Worker Utilization Report

Was this article helpful?

That’s Great!

Thank you for your feedback

Sorry! We couldn't be helpful

Thank you for your feedback

Let us know how can we improve this article!

Select at least one of the reasons
CAPTCHA verification is required.

Feedback sent

We appreciate your effort and will try to fix the article
