Workforce Reports - EEO Weekly Report

Modified on Mon, 16 Dec, 2024 at 8:42 AM

Report Description: this report is a weekly “at a glance” for EEO compliance. It contains the following information:

  • City name
  • Project name
  • Contractor name
  • Project code
  • Selected date range
  • CPR week ending date
  • Total hours worked
  • Classification hours by TJ (total journeyman), TA (total apprentice) and TL (total laborer)
  • Minority hours and dollars paid by MJ (minority journeyman), MA (minority apprentice) and ML (minority laborer)
  • Female hours and dollars paid by FJ (female journeyman), FA (female apprentice) and FL (female laborer)
  • Residency hours and dollars paid
  • Community hours
  • Number of pay periods
  • Subtotals and totals of all sections
  • Commitment percentages of goals
  • Commitment hours of goals
  • Actual percent of goals
  • Actual hours of goals

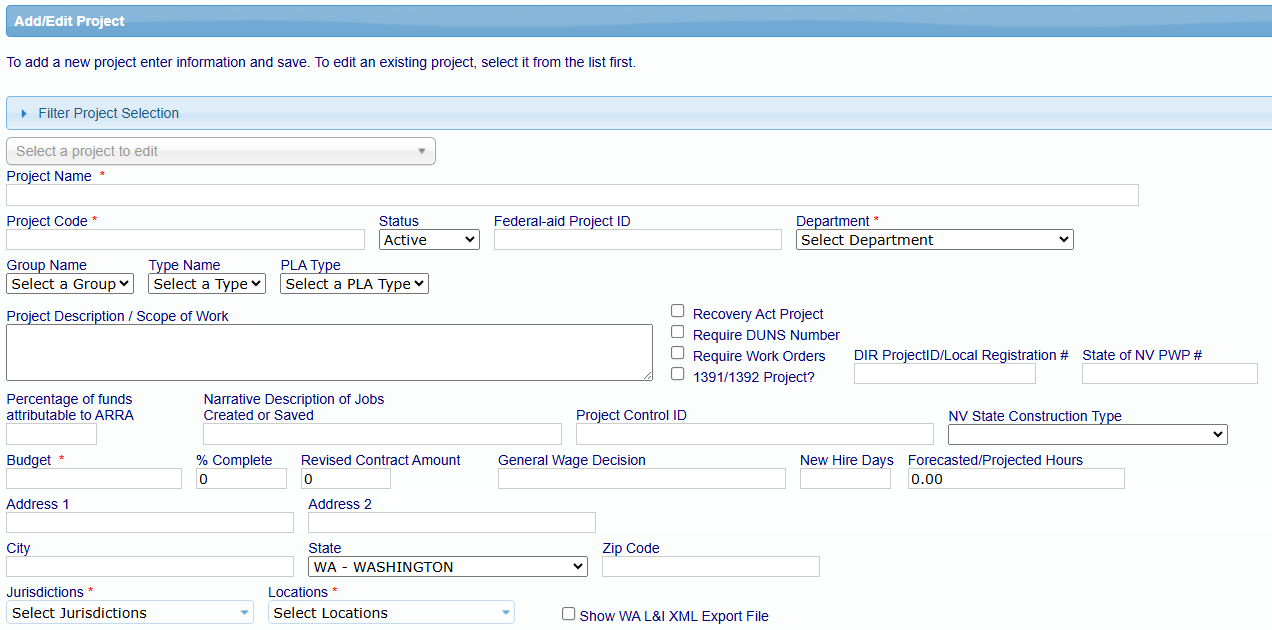

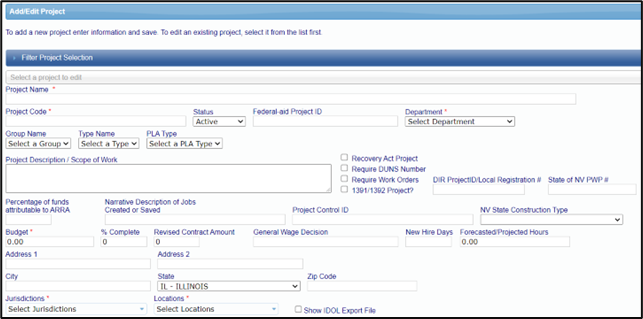

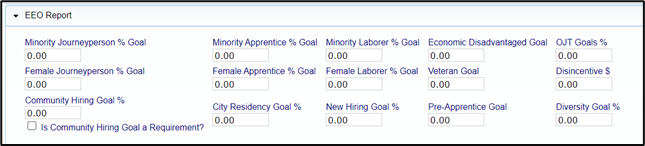

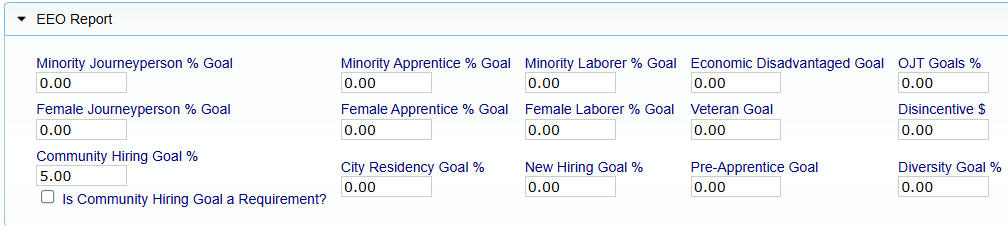

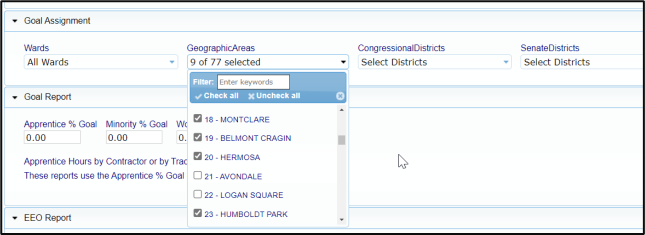

Preconditions: In order for information to populate accurately on the report, goal amounts, listed under the EEO Report section, need to be entered under Set Up > Add/Edit Project when a project is set up.  The Geographic Areas may also be required based on the Admin setup.

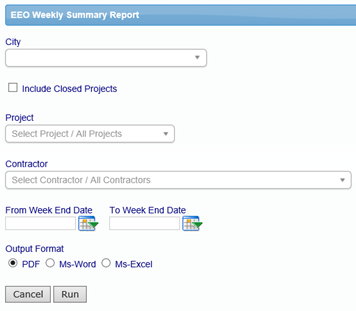

Parameters:

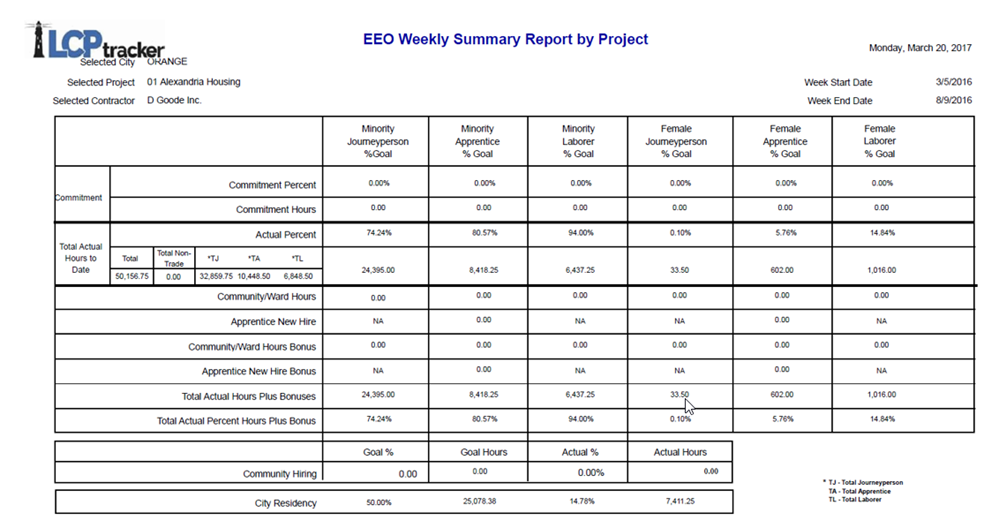

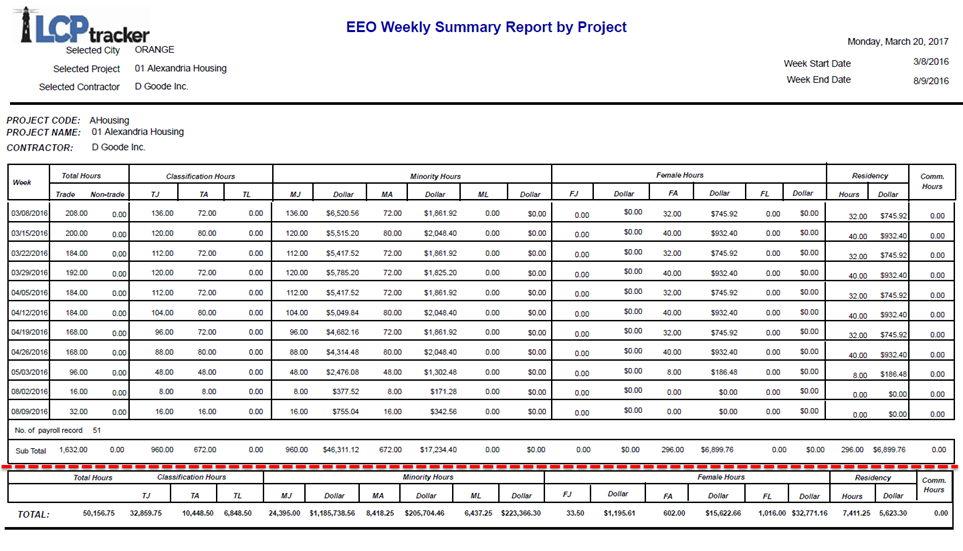

Report Sample:

Was this article helpful?

That’s Great!

Thank you for your feedback

Sorry! We couldn't be helpful

Thank you for your feedback

Let us know how can we improve this article!

Select at least one of the reasons
CAPTCHA verification is required.

Feedback sent

We appreciate your effort and will try to fix the article
